Salesforce MRP: plan materials from live orders, stock and supply

Axolt MRP runs natively inside Salesforce. It plans from the same sales orders, inventory, bills of materials and purchase orders your teams already use, so shortages surface while there is still time to act.

Plan materials from live demand, supply and stock on one shared Salesforce data model.

Native to Salesforce
No integration to maintain
Planning, purchasing and finance on one data model

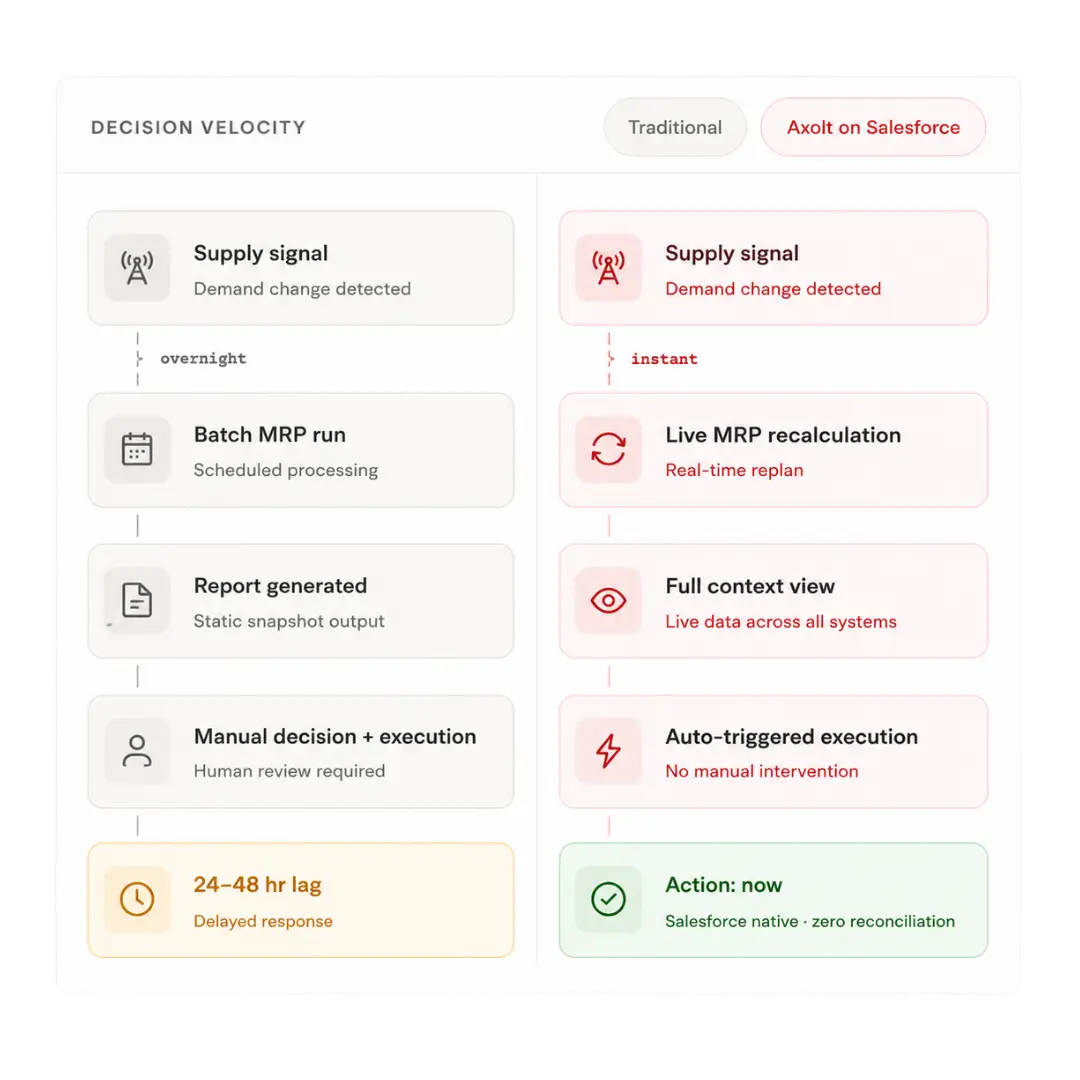

Velocity
Last updated 31 October 2026
Live demand Sales orders and forecasts
Live supply Stock, purchase orders and work orders
One plan Current position, not a stale snapshot

Salesforce MRP is material requirements planning that runs inside Salesforce. It works out what materials and sub-assemblies you need, how many and by when, using live demand from sales orders and forecasts, stock on hand, open purchase and work orders, bills of materials and lead times. Axolt MRP then raises purchase and production suggestions against the gaps it finds, on the same platform as your customers, inventory and finance.

The problem

Plans that react too late

Most MRP systems plan in batches. Between runs, a supplier slips, a large order lands or production falls behind, and the plan no longer matches reality.

Demand sits in CRM

New orders reach the plan late when demand has to be synced into a separate planning system.

Inventory is already out of date

Planners are asked to trust the last sync or count instead of the stock position now.

Exceptions live in spreadsheets

Decisions depend on who reviewed which exception, and when.

Purchasing acts elsewhere

Orders go out late or in the wrong quantities when action sits outside the planning system.

What fragmented planning costs

Shortages are found when a line stops
Expediting and premium freight erode margin unnoticed
Supply decisions are slower to approve and release
Finance sees the cost after the fact
Operations, purchasing and finance work from different versions of the plan

The cause is rarely a lack of data. It is the gap between the systems that hold demand, stock and supply, and the time it takes to bring them together.

How Axolt MRP works

Plan from records that already live in Salesforce

There is nothing to import before a plan can be trusted.

01

Demand is captured

Confirmed sales orders and forecasts feed the plan as they change in Salesforce.

02

Supply is checked

Stock on hand by warehouse, open purchase orders and work orders in progress are netted against demand.

03

Gaps are identified

Shortages are calculated through every level of the bill of materials, offset by lead times, with capacity constraints shown alongside.

04

Suggestions are raised

Purchase and production suggestions are created for each gap, with quantities and required dates, for release by planners or approval rules.

05

Execution is tracked

Purchase orders, work orders and their cost impact stay visible to operations, purchasing and finance.

Because MRP shares one data model with BOM management, production planning, capacity planning, purchase orders and manufacturing finance, every suggestion is made with the full picture.

Worked example

How MRP calculates what you need

Every MRP follows the same logic: netting, bill of materials explosion, lead-time offsetting, lot sizing and safety stock.

The worked scenario

The order: A customer orders 100 pumps (P-100), due in week 6. Assembly takes one week.

The bill of materials: Each pump needs one motor (M-10, bought in, lead time three weeks) and two brackets (B-20, made in-house in one week from 0.5 kg of steel each). Steel (S-5) is bought in 25 kg bars with a two-week lead time.

The stock position: 10 pumps, 30 motors, 40 brackets and 20 kg of steel are on hand. Another 20 motors are already on order, arriving in week 2. The motor has a safety stock of 10.

P-100 pump: 100 required by week 6; 10 on hand; net 90; production order for 90; release by week 5.
M-10 motor: 90 required by week 5; 30 on hand + 20 on order - 10 safety stock = 40 available; net 50; purchase 50; release by week 2.
B-20 bracket: 180 required by week 5; 40 on hand; net 140; production order for 140; release by week 4.
S-5 steel: 70 kg required by week 4; 20 kg on hand; net 50 kg; purchase 50 kg as two 25 kg bars; release by week 2.
Illustrative example.

The MRP logic

Netting

Gross demand minus stock and open supply gives the net requirement.

BOM explosion

A finished product requirement creates requirements for its components, level by level.

Lead-time offsetting

Each suggestion is dated back from when it is needed by its lead time.

Lot sizing and safety stock

Quantities are adjusted to buying rules and protected stock levels.

Batch MRP compared with continuous planning

How the plan updates matters

When inputs change, the age of the data matters as much as the planning logic.

Batch MRP in a separate system

Batch MRP

Updates on a schedule, often overnight

Demand is synced from a CRM into the planning system

Inventory reflects the last count or sync

Exceptions are exported and reviewed in spreadsheets

Action is taken in a different system

Cost impact is visible after the fact

Result: decisions are based on a plan that may already be out of date

Axolt MRP on Salesforce

Continuous planning

Updates as demand and supply change

Salesforce sales orders and forecasts feed the plan directly

Live stock is considered across warehouses

Exceptions are shown with the order, item and supplier in Salesforce

Purchase and work orders are raised on the same platform

Cost impact is visible before a purchase order is released

Result: planners can act from the current position

MRP does not need to wait for a separate system to catch up. Demand, supply, execution and finance share one Salesforce data model.

Clear to Build

Available is not the same as ready

You can have stock on the shelf and still be unable to build. One missing component stops the line.

Clear to Build checks the full BOM before release

It checks material availability across every component of the bill of materials before a work order is released.

Explore Clear to Build
Before work starts

Finish what you start

Validates availability for every component of the work order

Shows missing or short components before release

Connects shortages to purchase orders so gaps can be filled quickly

Prevents starting production you cannot finish

You do not start production unless you can finish it.

Platform capabilities

MRP planning and execution on one platform

Live demand signals, continuous planning and connected execution keep the plan current and actionable.

Live demand signals

New and changed Salesforce sales orders flow into planning without imports or sync jobs.

Continuous planning

Supply and demand changes trigger recalculation, so the plan reflects the current position.

Execution-linked workflows

Purchase and production suggestions sit next to the purchase orders and work orders that carry them out.

One version of the truth

CRM, inventory, manufacturing, purchasing and finance share one data model, with no reconciliation between systems.

Cost visibility before action

Connected manufacturing finance shows the cost of supply and replenishment decisions before purchase orders are released.

Agentforce ready

Axo AI on Agentforce can analyse demand, propose purchase orders and schedule changes, and record an audit trail while people approve consequential actions.

Planning and execution connected

MRP plans. Salesforce MES executes.

MRP decides what needs to be bought and made. Salesforce MES controls what happens on the shop floor: work orders, material consumption, work in progress and quality.

Plans are built on real production progress
Execution works from current requirements
Work orders, material consumption and WIP stay connected
Quality and traceability stay in the same operating model
Operations and finance see the same live position
On Salesforce

Planning, purchasing and manufacturing share the same data

Axolt connects MRP, production planning, MES, inventory, purchasing and finance in one platform.

What to check in an MRP system

Questions to ask in every demo, including ours

Compare the planning rules, traceability and exception handling that determine whether an MRP system works in your operation.

Safety stock

A protected quantity MRP will not plan to use. Ask: How is safety stock set per item and warehouse?

Lot sizing

Rules such as fixed quantities, minimums or multiples. Ask: Which lot-sizing rules are supported?

Lead times

Purchase, production and transfer lead times. Ask: Can lead times differ by supplier and site?

Planning horizon

How far ahead MRP plans. Ask: How is the horizon set, and can it differ by item?

Pegging

Which demand each supply order is for. Ask: Can a planner trace a purchase order back to the customer order?

Multi-site planning

Planning across warehouses and transfers. Ask: Are transfers between sites suggested?

Exception messages

Advice to expedite, defer or cancel. Ask: How are exceptions shown and prioritised?

Built for manufacturers

When reacting late is not an option

Built for make-to-order manufacturers, complex multi-level BOMs, variable demand and long or uncertain supply.

Make-to-order

Every order is different, so planning must respond to each one as it arrives.

Complex multi-level BOMs

Shortages hide several levels down; explosion and netting must reach every level.

Variable demand

Seasonal, project-based and lumpy demand makes yesterday’s plan unreliable.

Long or uncertain supply

Multi-tier suppliers and long lead times need early, accurate purchase signals.

Customer example

Northern Wide Plank

Northern Wide Plank faced tight production schedules, disjointed processes and manual accounting.

With Axolt, the team schedules manufacturing orders with live status and traceability.

Bills of materials and work orders support manual or automatic stock allocation.

Timed process cycles support more accurate forecasting. Read the case study.

Axolt MRP eliminates the lag between signal and action.

Agentforce ready

Planning with a person in control

Axo AI on Agentforce helps planners analyse demand and propose actions, with approvals for consequential changes.

Example request

Axo AI on Agentforce

“Cover all critical items for the next 30 days.”

Demand analysed

Across active orders, forecasts, stock and open supply

Reviewed

Purchase orders proposed

For the gaps the plan identifies

Reviewed

Schedule changes proposed

Against current capacity and requirements

Reviewed

Audit trail recorded

People approve consequential actions

Controlled

Agentforce turns a planner’s request into a traceable recommendation, while keeping people responsible for release decisions.

Frequently asked questions

Salesforce MRP FAQs

What is Salesforce MRP?

Salesforce MRP is material requirements planning that runs natively inside Salesforce. Axolt uses live sales orders, inventory, bills of materials and purchase orders on the same platform to calculate what you need, when you need it, and what to buy or build.

What inputs does MRP need?

Demand from sales orders and forecasts, bills of materials, stock on hand, open purchase and work orders, lead times, and planning rules such as safety stock and lot sizes. In Axolt these already live in Salesforce.

How is Axolt MRP different from batch MRP?

Batch MRP recalculates on a schedule, so plans can be based on yesterday’s position. Axolt recalculates as orders and supply change, and raises purchase and production suggestions on the same platform where they are carried out.

Do I need an integration between my CRM and MRP?

No. Because Axolt is built on Salesforce, demand comes directly from your sales orders, with no middleware or reconciliation.

Does Salesforce MRP connect to finance?

Yes. Axolt connects MRP with manufacturing finance, so the cost impact of supply decisions is visible before a purchase order is released.

What is Clear to Build?

A check that confirms every component of a work order is available before it is released, so you do not start production you cannot finish.

Does Axolt MRP work with Agentforce?

Yes. Planners can ask Axo AI on Agentforce to analyse demand and propose purchase orders and schedule changes, with an audit trail and approval before consequential actions.

What is the difference between MRP and a master production schedule?

The master production schedule states what finished products will be made and when. MRP works out the materials and sub-assemblies needed to deliver that schedule.
